The Inundation Risk Zone (IRZ): Understanding NJ’s Climate-Adjusted Flood Elevations

Envicon Group

Environmental & Civil Engineering Consultants

August 11, 2026
5 min read

The rules for building in New Jersey just changed, and if you’re reading this on June 22, 2026, you have exactly 28 days to decide how you’re going to handle it.

On January 20, 2026, the NJDEP officially adopted the Resilient Environments and Landscapes (REAL) rules. This wasn't just another regulatory tweak; it was a fundamental shift in how tidal flood hazard areas are defined and managed. For developers, investors, and attorneys, the primary headlines are the Climate-Adjusted Flood Elevation (CAFE) and the Inundation Risk Zone (IRZ).

At Envicon, we don’t sell bloated reports that sit on your desk. We sell cleared paths. Right now, that path is narrowing for anyone who hasn't secured their "legacy" status. Here is what you need to know about the new NJ flood elevations and why the current "one-year delay" is more of a countdown than a reprieve.

The New Math: CAFE vs. FEMA BFE

For years, the gold standard for flood elevation was the FEMA Base Flood Elevation (BFE). If FEMA said the 100-year flood was 10 feet, you built to that plus a little freeboard.

Under the NJPACT REAL rules, that math is obsolete for tidal areas. The state has introduced the Climate-Adjusted Flood Elevation (CAFE), which is set at FEMA BFE + 4 feet.

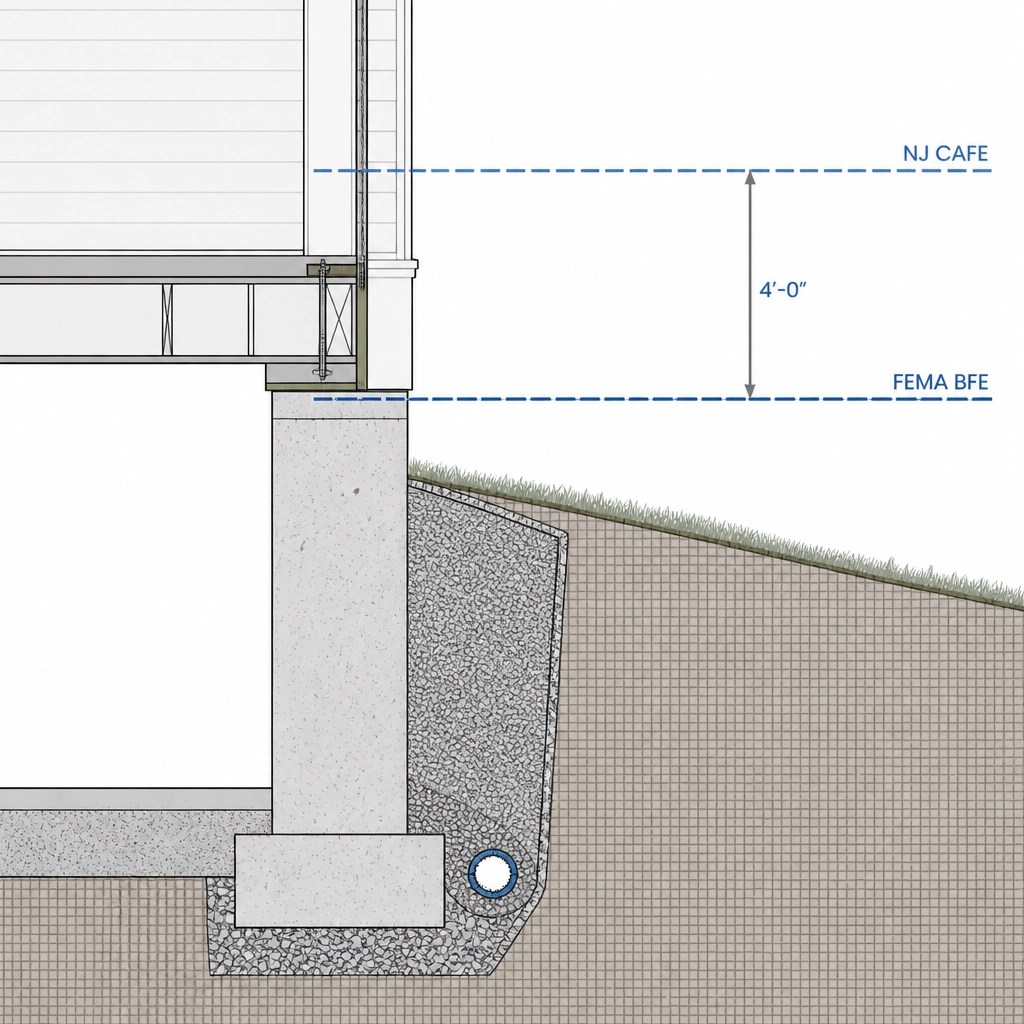

Technical diagram showing FEMA BFE vs NJ CAFE +4ft elevation

This 4-foot jump is designed to account for sea-level rise projections through the year 2100. If your site has a BFE of 10 feet, your new design flood elevation for NJDEP permitting is 14 feet. This isn't a suggestion; it's a requirement for site engineering and habitable floor heights.

Why this matters now:

  • Design Impact: Foundations, mechanical systems, and access points all have to move up. This changes your floor-area ratio (FAR) and your construction costs.
  • Financing Gap: Lenders are already looking at these rules. A project designed to old standards that doesn't meet CAFE might be viewed as a "stranded asset" before the first shovel hits the dirt.
  • Regulatory Friction: If your project isn't elevated to CAFE, you aren't getting an NJDEP permit: period: unless you fall under the legacy protections.

Defining the Inundation Risk Zone (IRZ)

Beyond the vertical elevation (CAFE), the NJDEP has introduced a horizontal boundary: the Inundation Risk Zone (IRZ). This zone identifies land that is currently above the mean high water line but is projected to be permanently inundated by the year 2100.

Technically, the IRZ includes all land within five feet vertically of the current Mean Higher High Water (MHHW) elevation.

GIS map showing the Inundation Risk Zone overlay in coastal NJ

Contrary to some of the early panic in the industry, the IRZ is not a no-build zone. However, it is a "build-with-scrutiny" zone. If your project falls within the IRZ: especially residential developments or critical infrastructure: you are now required to submit:

  1. A Sea-Level Rise Impact Assessment: How will your site function when the surrounding streets are tidally flooded?
  2. An Alternatives Analysis: You must prove that you've tried to minimize the risk or that there is no feasible alternative to building in that zone.
  3. Risk Acknowledgement: Formal documentation that you recognize the long-term risk of the site becoming permanent water.

The July 20th Deadline: The Legacy Window is Closing

There has been a lot of talk about "delays" in the implementation of NJPACT. Let’s be direct: the delay is over. The rules are adopted.

The only "delay" that matters right now is the 180-day legacy window. Projects that submit an administratively and technically complete application to the NJDEP by July 20, 2026, can still be reviewed under the old standards.

If you miss that deadline by a single day, or if your application is deemed incomplete, you are subject to CAFE and IRZ requirements.

"Waiting for the next regulatory delay is not a business strategy; it's a liability. The projects that move forward are the ones that treat these deadlines as hard stops." : Jason Pancoast, CEO of Envicon Group.

The Envicon Edge: Moving Beyond the "Black Box"

When you hire a national firm to handle your NJDEP permitting, your project often disappears into a black box. You don't know which junior staffer is writing your report or which reviewer they are (or aren't) talking to.

Envicon works differently. We are a family-owned, PE-led firm that has spent 20 years building direct relationships with the NJDEP and local regulators. We don't just hand you a report and leave you to figure it out. We sit at the table with the reviewers to find the alignment that actually gets your project approved.

Envicon engineer and developer collaborating on site plans

Our proprietary project management infrastructure gives you real-time visibility. You’ll know exactly where your application stands as we race toward that July 20th deadline. We provide the technical precision of a large firm with the urgency and accountability of a partner who is on your site at 7:00 AM.

Summary: Your 30-Day Action Plan

The Inundation Risk Zone and Climate-Adjusted Flood Elevations are the new reality for New Jersey development. To keep your project on track, you need to act before the July 20th cutoff:

  • Confirm your Zone: Check if your site falls within the IRZ using the latest NJDEP mapping.
  • Audit your Elevations: Does your current design meet the BFE + 4ft standard? If not, do you have a plan to file for legacy status in the next three weeks?
  • Secure your Team: Ensure your consultants are not just aware of the rules, but are actively coordinating with the NJDEP to ensure your application is "technically complete" before the window shuts.

We don't sell reports. We sell cleared paths. If your project is facing a regulatory hurdle, contact us today to ensure you aren't left underwater, literally or figuratively.

Take the Next Step


Envicon Strategic Solutions logo – MAIN
Envicon Strategic Solutions logo - MAIN

Stay Updated

Get the latest environmental engineering insights delivered to your inbox.

No spam. Unsubscribe anytime.

Initializing security...

Related Articles

Sediment and Waterfront Remediation NY and NJ 2026: MGP Residuals, Bulkheads, and Dredge Material Management
Remediation & Brownfields

Sediment and Waterfront Remediation NY and NJ 2026: MGP Residuals, Bulkheads, and Dredge Material Management

A waterfront parcel in Jersey City, Bayonne, Newark, Brooklyn, or Queens rarely has a single environmental problem. The shoreline may contain manufactured gas plant residuals, coal tar, PAH-impacted sediment, historic fill, buried debris, and decades of industrial discharge. The bulkhead may be structurally compromised. The seabed may require dredging or capping. Tidelands, riparian rights, wetlands, […]

NJDEP REAL Legacy Period July 2027: Which Development Permits Can Still Use Pre-REAL Rules
Regulatory Updates

NJDEP REAL Legacy Period July 2027: Which Development Permits Can Still Use Pre-REAL Rules

DRAFT | Pending approval. New Jersey’s Resilient Environments and Landscapes rules, known as REAL, took effect on January 20, 2026. The rules changed requirements for coastal development, freshwater wetlands, stormwater, and flood hazard areas. NJDEP originally created a 180-day legacy period ending July 20, 2026. The Department later proposed extending […]

NYSDEC Part 617 Disadvantaged Community Screening: A 2026 SEQRA Checklist for NYC Developers
Regulatory Updates

NYSDEC Part 617 Disadvantaged Community Screening: A 2026 SEQRA Checklist for NYC Developers

New York’s amended 6 NYCRR Part 617 took effect on June 12, 2026. For developers, the change is direct: SEQRA review must now address whether a proposed action may cause or increase a disproportionate pollution burden on a disadvantaged community. That analysis belongs in the environmental review record. It can […]

New York EIS Timeline 2026: One-Year and Two-Year SEQRA Planning for Manhattan and Brooklyn Projects
Regulatory Updates

New York EIS Timeline 2026: One-Year and Two-Year SEQRA Planning for Manhattan and Brooklyn Projects

For developers planning a Manhattan or Brooklyn project, the New York EIS timeline 2026 now has clearer statutory benchmarks. New York’s 2026 SEQRA changes establish a one-year outside period for the lead agency to determine whether an Environmental Impact Statement is required. For qualifying permit or authorization actions, the agency must generally prepare and make […]

New Jersey Flood Hazard Area Permit Completeness: What REAL Rule Applications Need Before NJDEP Review
Water, Stormwater & Dewatering

New Jersey Flood Hazard Area Permit Completeness: What REAL Rule Applications Need Before NJDEP Review

A New Jersey flood permit does not become complete just because it was uploaded to NJDEP. For waterfront and flood-zone projects in Jersey City, Hoboken, Bayonne, Newark, Hudson County, Bergen County, and Essex County, NJDEP must have enough reliable information to evaluate the regulated activity. That means more than an application form. It means verified […]

Need Expert Guidance?

Our team can help you navigate complex environmental challenges.
